Most construction projects have a gap between what the design costs and what the client can spend. Value engineering is how you close that gap without damaging the building.
It is also one of the most misunderstood terms in construction. Some treat it as cost-cutting; others assume it means lower quality. In reality, value engineering is a structured review of what each part of a project needs to do, and how to deliver that function at the lowest whole-life cost.
Quick answer: Value engineering (VE) in construction is a systematic review of a project’s components to deliver the same function, quality and safety for less cost. It works best early, during concept and design development, before tender packages are issued and construction starts.
What Value Engineering Means in Construction
Value engineering began at General Electric in the 1940s as a way to find cheaper materials that did the same job. Construction adopted it because the same question applies to every building element: does this component perform its function, and is it the most economical way to do so?
Answering that question well requires:
- A clear understanding of what each component must do, not just how it looks on the drawings
- Knowledge of alternative materials, methods and specifications that achieve the same result
- Reliable quantities and rates to compare the real cost of each option
- The judgement to spot when a cheaper option hides a compromise
That last point is where VE often goes wrong. A cheaper material that performs the same function is a VE win. A cheaper material that fails early, needs more maintenance or adds programme risk is not, even if the upfront number is lower. Our value engineering services are built around that distinction.
How the Value Engineering Process Works
A structured VE exercise follows the same six phases whether it is run in-house or by a preconstruction partner.
| Phase | What happens | Who leads |
|---|---|---|
| 1. Information | Gather drawings, specifications, programme and cost plan. Understand design intent and constraints. | Estimator or QS |
| 2. Function analysis | Define what each major component must do. Separate needs from wants. | VE lead and design team |
| 3. Creative | Generate alternatives: different materials, methods, systems or sequences. | Multi-discipline team |
| 4. Evaluation | Score each option on cost, programme, quality, risk and compliance. Reject hidden trade-offs. | Estimator and engineer |
| 5. Development | Detail the shortlist: revised drawings, specifications and re-costed quantities. | Design team |
| 6. Presentation | Present each recommendation with its cost, programme and quality impact. | Project lead |
Function analysis is what separates real VE from cost-cutting. Jumping from “this is expensive” to “use a cheaper version” skips the key question: what does this element actually need to do?
Phases 1 and 4 also depend on accurate quantities. You can’t compare alternatives without reliable base quantities to price. Our guide to construction takeoff and estimation explains how that groundwork is done.
When to Use Value Engineering, and When Not To
Used at the right time, VE produces real savings. Used at the wrong time, it creates abortive design fees, programme disruption and contractor disputes.
| Use VE when… | Avoid VE when… |
|---|---|
| The design is at RIBA Stage 2–3 (UK) or schematic and design development (US) | Construction has started and changes create variations and delay |
| The cost plan exceeds the client’s budget | Tender prices are in against a fixed specification |
| A package comes in well over budget at tender | The specification is a fixed client, heritage or planning requirement |
| New materials or methods are now available | Savings are small compared with redesign cost and risk |
| The programme can absorb design revisions | The exercise is being used to cut safety-critical elements |

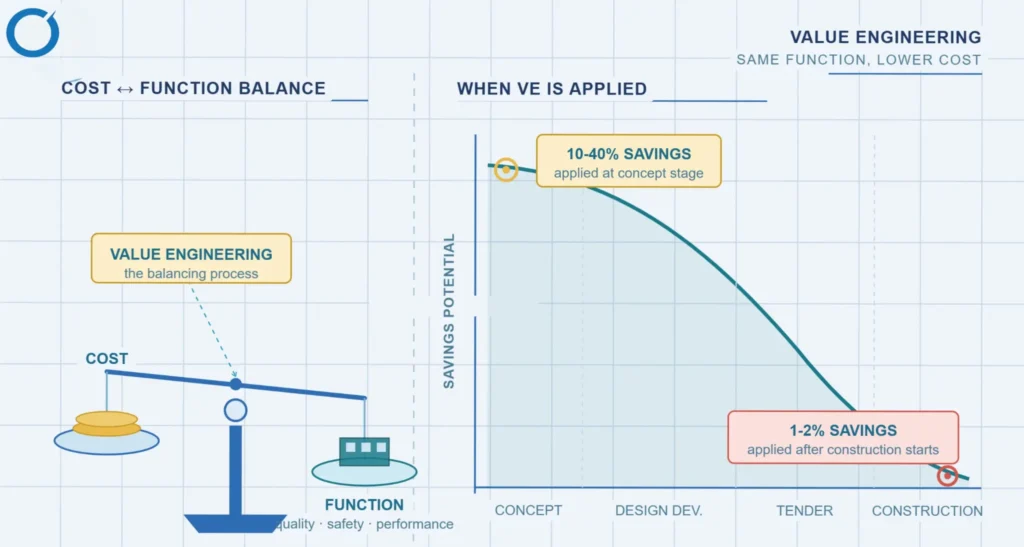

The earlier VE starts, the more it can save. At concept stage the design is flexible and alternatives are cheap to test. After construction starts, most savings are swallowed by redesign fees, contractor variations and delay. Knowing how much construction estimating costs helps you budget for the exercise itself.
Over budget at design stage?
Send your drawings and cost plan. We’ll re-cost the alternatives and show where the real savings are, with a fixed quote within 24 working hours.
Value Engineering by Trade: What Changes and What Doesn’t
VE opportunities vary by trade. Some elements have many genuine alternatives; others only have options that look cheaper but carry hidden programme, maintenance or compliance costs. On larger projects, BIM services let you test structural, MEP and facade alternatives in the model before the design is fixed.
Structural frame
Steel versus concrete is one of the most common VE decisions on commercial projects. The right answer depends on spans, programme and the local labour market, and neither is always cheaper. Accurate structural steel estimating makes the comparison reliable.
External envelope
Brick, render, rainscreen cladding, panel systems and curtain wall all keep weather out at very different costs. The VE risk is thermal performance and maintenance life: a cheaper facade that needs frequent resealing can cost more over the building’s life.
MEP systems
Mechanical, electrical and plumbing systems are usually the biggest VE opportunity on commercial and residential projects. Equipment selection, plant sizing, pipe sizing and distribution routes all have real alternatives, but finding them takes trade knowledge. General estimators without MEP estimating experience often miss the best options. Testing them in a coordinated model also avoids the rework that makes late changes expensive; see how BIM reduces rework.
Finishes
Flooring, wall finishes, ceilings and ironmongery carry the lowest risk of hidden costs, because their function is mainly aesthetic. The test is simple: equivalent appearance and durability at lower cost. Flooring estimating is a typical starting point.
What not to value engineer
Fire protection, waterproofing, structural connections and safety-critical MEP systems should never be changed on cost alone. If they fail, the cost isn’t a construction cost but a liability, and that is always larger.

A Simple Value Engineering Example
Consider an office ceiling specified as a bespoke metal system. The function is to conceal services, provide access and meet acoustic and fire requirements. Function analysis shows a standard lay-in grid with acoustic tiles meets every one of those needs. The team re-costs both options, confirms the fire rating and acoustic performance, checks lead times, and finds the standard system is cheaper to buy and install and just as easy to maintain.
That is value engineering: the function stays the same, and the cost and risk are both documented. Simply swapping to “a cheaper ceiling” without those checks would be specification reduction.
Three VE Mistakes That End Up Costing More
1. Treating specification reduction as value engineering
Choosing a cheaper product without proving it performs the same function is not VE. It creates legal risk if the product fails, contractual risk if it breaches the specification, and practical risk if it doesn’t perform.
2. Applying VE too late
The most common mistake is starting VE after tender packages are issued. Contractors have priced a fixed specification, so every change brings variation mark-ups, redesign fees and programme risk. BIM coordination before tender lets teams check clashes, ceiling space, service routes and structural constraints while changes are still cheap.
3. Ignoring whole-life cost
A material that is cheaper to buy but needs far more maintenance is rarely a saving. Every VE recommendation for building fabric, plant or the envelope should include a whole-life cost comparison, not just the purchase price.
Start Value Engineering Earlier Than You Think
Value engineering isn’t a rescue operation for projects already over budget. By then the design is fixed and procurement is underway. The teams that get the most from VE build it into preconstruction, when the design is still flexible and an hour of function analysis is worth more than a week of cost-cutting on site.
For contractors juggling several bids, an offshore preconstruction team can work through alternatives without pulling estimators off live tenders. Read how offshore teams help contractors scale.
Need a value engineering review?
Optimar Precon re-costs design alternatives, checks functional equivalence and documents cost, programme and risk for each option, for projects in the USA, UK, UAE and Canada. Every job starts with a fixed quote within 24 working hours.
FAQs
What is the difference between value engineering and value management?
Value management is broader: it looks at project objectives and stakeholder priorities. Value engineering focuses on design components and their cost against function. In construction the terms are often used interchangeably, though large infrastructure projects usually keep them separate.
Who should carry out value engineering on a construction project?
VE works best when led by an experienced estimator or quantity surveyor, supported by specialists for the elements under review, such as MEP engineers on services-heavy projects or envelope specialists on facade-heavy ones. Exercises run only by non-technical managers tend to become specification cuts.
Does value engineering affect the programme?
It can go either way. Off-site prefabrication can shorten the programme, while late design changes or substitute materials with longer lead times add risk. Every VE recommendation should include a programme impact alongside the cost.
Can value engineering help you win more bids?
Yes, if it happens before tender. Contractors who run VE during preconstruction can offer a sharper price without cutting margin, and many clients now expect VE options in larger tender submissions. See how to improve your bid success rate.
Is value engineering only for large projects?
No. On smaller projects it’s simply less formal: a structured review of specification and method alternatives rather than a multi-day workshop. Applied consistently across a portfolio of smaller jobs, it can still improve margins meaningfully.
